SAP Business One Implementation Guide: Costs, Timeline, and Best Practices
Implementing SAP Business One is not a software project. It is an operational shift.
Most companies begin evaluating ERP because something in the business is no longer scaling.
Month-end close takes too long.
Inventory numbers do not match across locations.
Teams rely on spreadsheets to reconcile purchasing, production, and financial data.
As transaction volume increases, these inefficiencies become harder to manage and more expensive to ignore, especially as ERP market trends and adoption continue to reflect growing demand for integrated systems across finance and operations.
SAP Business One addresses this by bringing financials, inventory, purchasing, production, and reporting into a single unified SAP Business One ERP software platform, so teams no longer have to reconcile data across multiple systems.
But the value of the system is not in the software alone. It depends on how well it is implemented.
A successful SAP Business One implementation aligns the system with how your business operates, including workflows, reporting structures, approval processes, and day-to-day execution.
In most implementations, the difference between success and frustration is not the technology. It is usually unclear requirements, inconsistent data, or a lack of internal ownership that creates problems. Planning discipline and accountability matter more than features.
This guide breaks down the SAP Business One implementation process step by step, including what happens in each phase, typical timelines and cost ranges, common mistakes to avoid, and how to structure your team for a successful rollout.
At Clients First, we have worked with manufacturers and distributors across hundreds of ERP implementations. The pattern is consistent: companies that treat ERP as a business initiative, not just a software install, achieve stronger adoption, more accurate reporting, and more predictable long-term results.
If you are planning an SAP Business One implementation, this guide will help you set realistic expectations, control costs, and move forward with clarity.
What Is an SAP Business One Implementation?



An SAP Business One implementation is the process of configuring and deploying SAP Business One ERP software, so it reflects how your business operates.

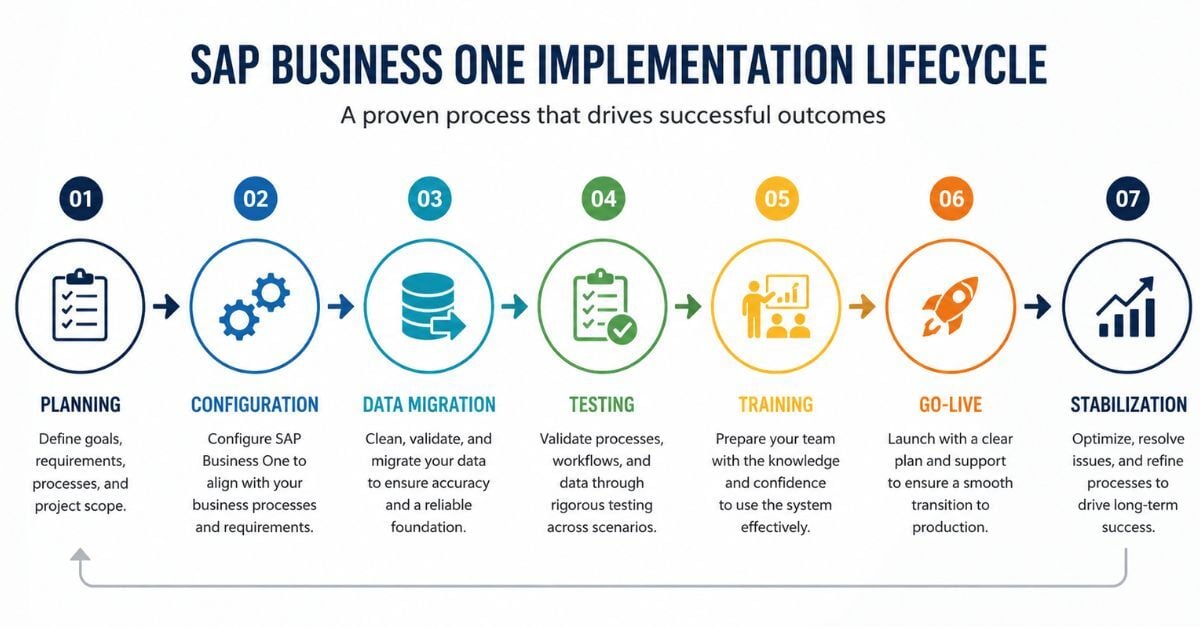

It is not a one-time setup. It is a structured effort to align financials, inventory, purchasing, production, and reporting into a single system your team can rely on every day.
In most implementations, that work breaks down into a few core stages:
- Planning and requirements definition
Documenting how your business currently operates, where the gaps are, and what needs to improve - System configuration
Setting up financial structures, inventory rules, approval workflows, and transaction logic based on your operations - Data migration
Cleaning and importing customers, vendors, items, and balances so reporting starts from a reliable baseline - Testing
Running real scenarios across departments to confirm everything works the way it should - Training and adoption
Preparing users to do their jobs in the new system, not just navigate the screens - Go-live and stabilization
Moving into production and resolving issues as the business transitions to the new process
Why Implementation Matters More Than the Software
SAP Business One is a mature ERP platform. The software is rarely the problem.
The hard part is making sure the system reflects how your teams buy, build, sell, and report.
In real-world deployments, issues usually come from:
- Processes that were never clearly defined before configuration
- Inconsistent or incomplete data carried into the new system
- Departments working differently than expected
- Users are not fully trained or aligned on the new workflows
When these problems are not addressed early, they show up during testing or after go-live—when they are more disruptive and more expensive to fix.
If those decisions are handled poorly upfront, companies usually pay for it later through rework, reporting issues, and low user adoption.
When implementation is handled well, the payoff is not just a smoother go-live.
It is stronger reporting, better visibility, and more consistent execution across the business, the same core benefits of SAP Business One that companies are usually trying to achieve in the first place.
What Success Looks Like
Go-live is not the finish line.
A successful SAP Business One implementation reaches a point where the system becomes part of daily operations:
- Financials reconcile without manual workarounds
- Inventory reflects real-time activity across locations
- Teams trust the data they are working from
- Reporting is consistent across departments
In most implementations, this level of stability comes from getting the fundamentals right early: clear processes, clean data, and consistent execution.
Not more features. Better alignment.
Why This Matters Before You Start
Many companies approach ERP expecting the software to fix operational issues on its own.
In practice, SAP Business One will expose gaps in process, data, and accountability. That is not a flaw in the system; it is part of the value.
The companies that see the best results treat implementation as a business initiative. They define how they want to operate, then configure the system to support it.
That is what keeps projects on track and what ultimately determines whether the system delivers long-term value.
SAP Business One Implementation Phase 1: Pre-Implementation Planning
Pre-implementation planning is when most ERP projects either stay on track or start creating problems that surface later.
Before any configuration begins, your team needs clarity on how the business operates today and where it needs to improve. Without that, the system ends up reflecting assumptions instead of real workflows.
In most implementations, this phase determines how smoothly everything else runs: scope, cost, timeline, and the system's usability after go-live.

Define Clear Business Objectives
Every ERP project starts because something is not working. But "we need a new system" is too vague to guide scope, budget, or design decisions.
The objective needs to be specific and measurable.
For example:
- Reduce the month-end close from 10 days to 3
- Improve inventory accuracy above 95%
- Eliminate duplicate data entry between systems
- Gain real-time visibility across locations
These targets give the project direction. They help prioritize requirements, guide configuration decisions, and create a clear way to evaluate success later.
In real-world implementations, teams that define clear outcomes early tend to move faster and avoid unnecessary rework.

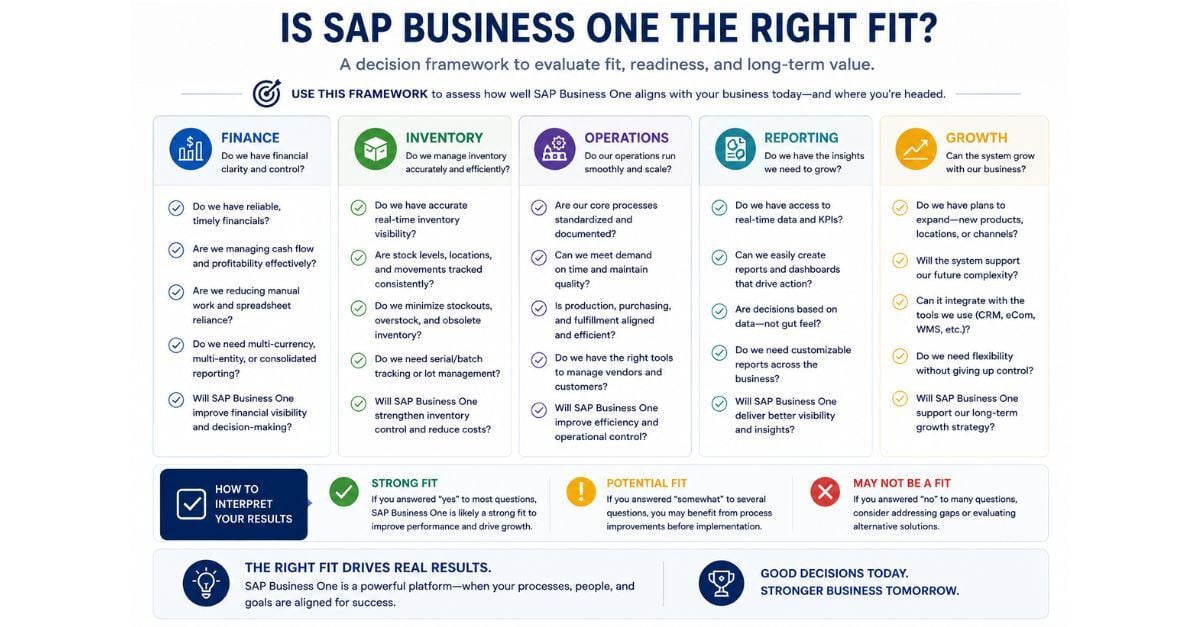

Conduct a Requirements and Gap-Fit Analysis
Once objectives are clear, the next step is to understand how your current processes compare to what SAP Business One supports.
This is done through a structured gap-fit analysis.
At a practical level, you are answering:
- What does the business need to do?
- What does SAP Business One already handle?
- Where are the gaps?
Those gaps typically fall into three categories:
- Configuration (using standard functionality with the right setup)
- Add-ons (leveraging proven third-party tools)
- Customization (building something new when required)
In most implementations, over-customization creates more problems than it solves. It increases costs, complicates upgrades, and adds long-term maintenance.
The better approach is to stay as close to standard functionality as possible and only introduce changes when there is a clear operational benefit.
Assign the Right Internal Team
ERP implementation cannot be delegated entirely to a partner. Internal ownership is what keeps the project moving.
At a minimum, you need:
- Executive sponsor
Sets priorities, resolves conflicts, and keeps the project aligned with business goals - Project lead / internal champion
Manages day-to-day coordination and works directly with the implementation team - Department leads
Represent finance, operations, warehouse, production, and other functional areas
In most implementations, delays are not caused by the system. They come from unclear ownership or slow decision-making. When the right people are engaged early, projects move more predictably.
Establish Governance and Communication Cadence
ERP projects involve constant decisions. Some are small configuration choices. Others affect financial reporting or operational workflows.
Without structure, those decisions tend to stall.
Best practice is to establish:
- Weekly or bi-weekly project meetings
- Clear documentation of decisions and action items
- A defined escalation path when issues are not resolved
That structure matters because unresolved decisions slow configuration, delay testing, and create confusion across departments.

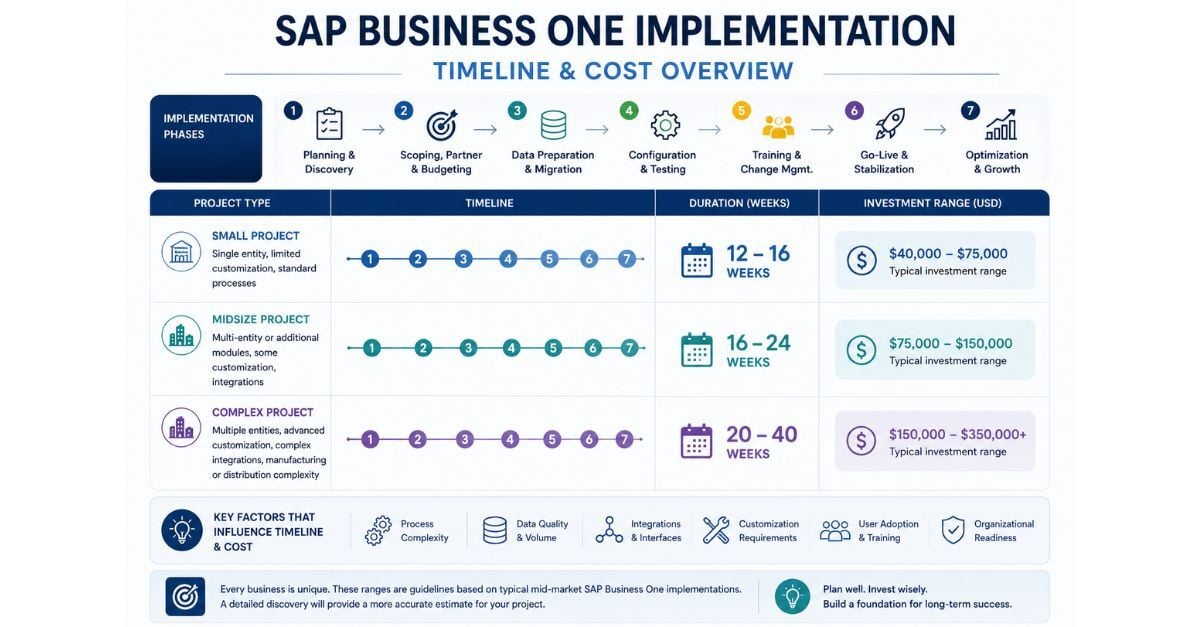

Cost Considerations: Planning Phase
Pre-implementation planning typically represents 10–15% of total implementation cost.
This includes:
- Discovery workshops
- Process mapping
- Initial system design
- Project planning and documentation
Some companies try to compress this phase to save time or budget.
In practice, that usually leads to:
- Scope changes during configuration
- Additional consulting hours
- Delays in testing and go-live
Well-defined planning does the opposite. It reduces downstream cost by limiting rework and keeping the project focused.

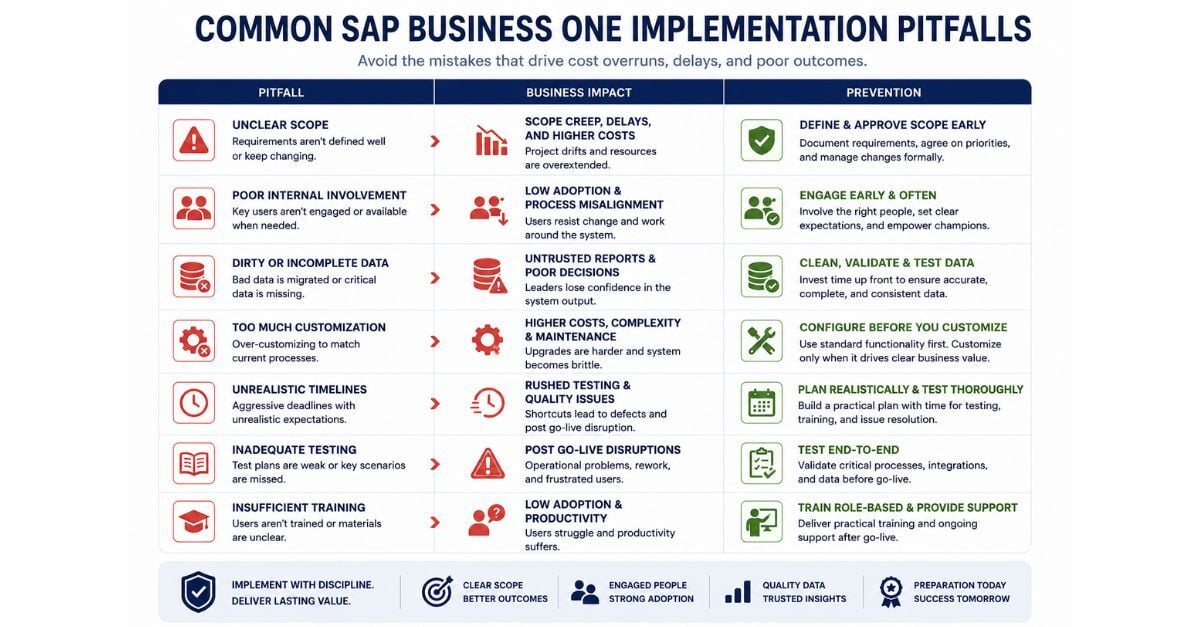

Common Mistakes in This Phase
This is where projects often start to drift, even if that is not obvious at the time.
Common issues include:
- Requirements that are too high-level or incomplete
- Assuming processes will be figured out during configuration
- Underestimating the effort required to clean and validate data
- Assigning internal resources who are unavailable or stretched too thin
- Skipping structured workshops to move faster
These decisions typically do not save time. They shift effort later in the project, where changes are harder and more expensive to make.
What Good Planning Looks Like
A strong planning phase creates clarity across the project.
You should have:
- Clearly defined business objectives
- Documented workflows and requirements
- Agreement on scope and priorities
- Identified gaps and how they will be addressed
- A realistic timeline and budget
At that point, the team can make decisions faster because expectations, ownership, and direction are clear.
SAP Business One Implementation Phase 2: Scoping, Partner Selection, and Budgeting
Once the planning work is complete, the next step is to turn it into an actual project.
This is the point where decisions start to carry weight. You are no longer talking in general terms about goals and process issues. You are defining what will be included, who will help implement it, and what the investment will really look like.
In most implementations, this is also where projects either become more predictable or start to lose definition.

Define Scope Before You Talk About Price
Before anyone can give you a meaningful budget, the scope has to be clear.
That means defining things like:
- Which parts of SAP Business One are being implemented
- How many users, departments, or locations are involved
- What outside systems need to connect
- What reporting, approvals, and workflows need to be supported
Without that level of detail, pricing remains just an estimate based on assumptions.
This is one of the more common issues companies encounter early on. They ask for the cost before the project has been defined well enough to price accurately. Then, as details start to surface, the budget changes, and confidence in the project drops with it.
A clear scope will not prevent every change, but it gives the project a much more stable starting point.
Choose the Right Implementation Partner
Once the scope comes into focus, partner selection becomes the next major decision.
SAP Business One is only part of the equation. The way it is implemented matters just as much.
A good partner should be trying to understand how your business runs before talking too much about software. They should ask about reporting pain points, operational bottlenecks, approval processes, inventory challenges, and where teams are relying on manual workarounds today.
They should also be able to explain:
- How they run projects
- What is included in their estimate
- Where they see risks
- When configuration makes sense versus add-ons or custom development
This is not just about technical capability. It is about whether the partner can translate business requirements into practical implementation decisions.
Be cautious if a partner moves too quickly into demos, gives broad estimates with little detail, or treats every requirement as a customization opportunity.
That usually creates problems later.
What to Look for in an SAP Business One Partner
The best partner is not always the one with the lowest price or the flashiest demo. It is usually the one that brings the most clarity.
A strong implementation partner will typically have:
- Experience in your industry
- A structured project approach
- Clear communication around scope, timing, and responsibilities
- A practical view of what should be configured versus customized
- A willingness to challenge assumptions when something adds complexity without enough value
That last point matters more than many companies expect.
In real-world implementations, good partners do not just say yes to everything. They help you make better decisions. They know where standard functionality is enough, where an add-on is the better path, and where customization may create a longer-term burden than benefit.
The right partner should feel like an advisor who is helping you reduce risk, not just a vendor trying to get the project started.
That is why choosing the right SAP partner matters just as much as selecting the right software.

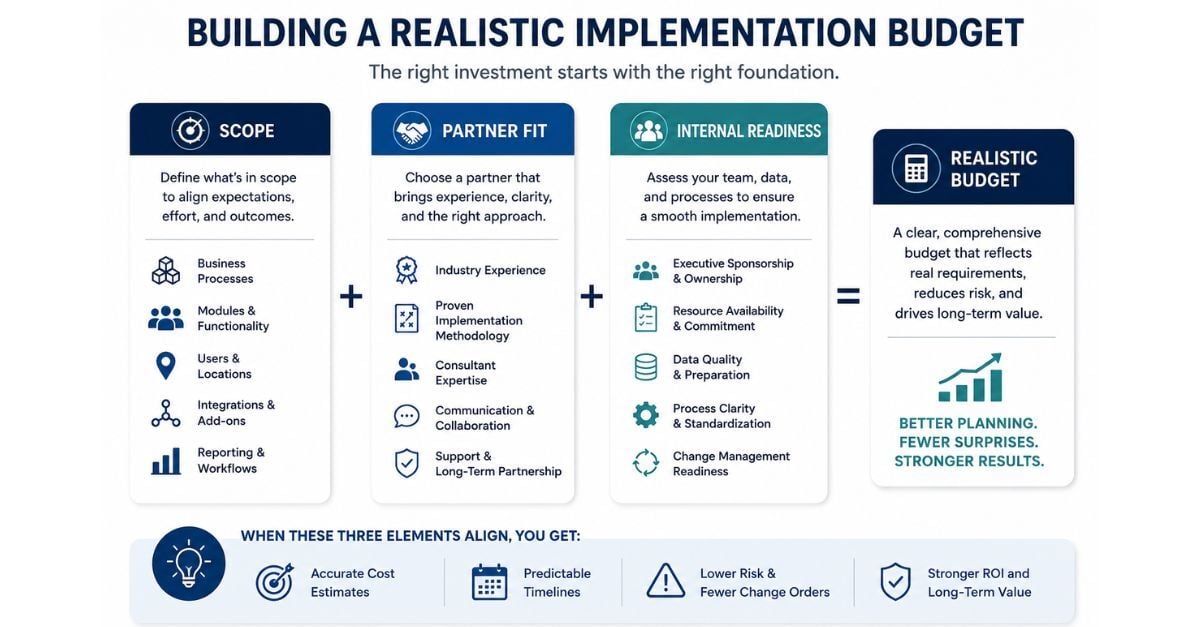

Build a Budget That Reflects the Real Work
Once scope and partner fit are clearer, budgeting becomes much more useful.
At that point, the budget should cover more than just software licenses. It should reflect the full implementation effort, including:

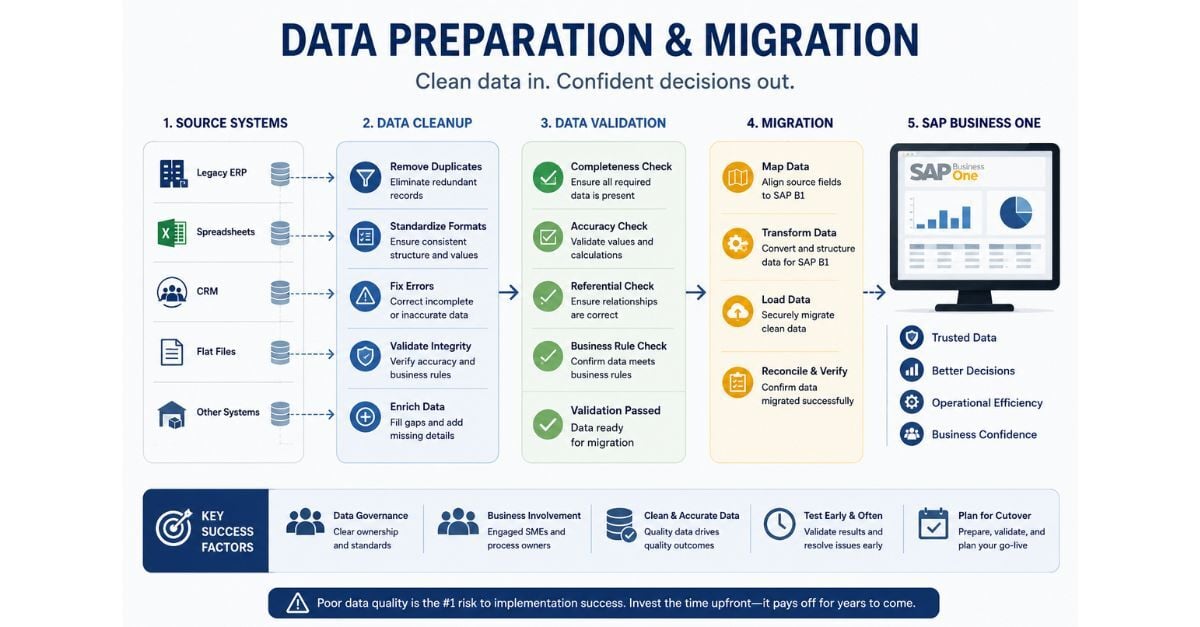

- Configuration and consulting services
- Data migration
- Testing and project management
- Add-ons or outside integrations
- User training
- Internal time from your team
One of the more common misconceptions in ERP projects is assuming the software is the main cost.
In practice, ERP budgeting requires the same kind of ERP capital investment discipline as any other major operational initiative, because the larger investment is usually the work required to make the system fit the business properly.
Usually, it is not.
In most implementations, the larger investment is the work required to make the system fit the business properly. That includes decisions around setup, data, workflows, reporting, and adoption.
That is why budgeting only around the license cost usually leads to underestimating the project.
Leave Room for Change
Even well-run projects change.
A report that seemed simple becomes more involved. A process that looked straightforward in discovery turns out to work differently across departments. An integration requires more effort than expected. That is normal.
For that reason, most companies should plan for a contingency buffer of around 10 to 20 percent.
That is not a sign that the project was scoped poorly. It is a sign that the budget reflects how ERP projects work.
Without that buffer, even reasonable adjustments can make it feel like the project is going off course when it is simply adapting to the business's needs.
Cost Considerations in This Phase
Scoping, solution design, partner input, and early project definition often account for roughly 25 to 35 percent of total implementation cost.
That typically includes:
- Detailed scoping sessions
- Solution design discussions
- Early planning and estimation
- Initial configuration decisions
Some companies hesitate to spend too much time or money in this phase because they want to get moving.
But in practice, rushing through this part usually makes the rest of the project more expensive. The cost does not disappear. It just shows up later as rework, change requests, and delays.
This is one of the phases where better discipline usually leads to better cost control.
Where Companies Get into Trouble
This phase is often where projects begin to lose predictability.
Common issues include:
- Starting before the scope is fully defined
- Choosing a partner based mostly on price
- Accepting vague proposals without a detailed breakdown
- Underestimating how much work integrations will require
- Not spending enough time on reporting and workflow decisions
None of those issues are unusual. But they do create problems later, especially once configuration begins and teams realize they were not working from the same assumptions.
What Good Scoping Looks Like
By the end of this phase, the project should feel defined enough that the team can move forward without making major assumptions.
You should have:
- A documented scope
- A realistic estimate tied to that scope
- Clear roles for both your team and the partner
- Visibility into risks, dependencies, and likely change areas
- A project plan that reflects how the business actually operates
That level of definition does not make the project rigid. It makes it manageable.
And in most implementations, that is what gives companies the best chance of staying on track.
SAP Business One Implementation Phase 3: Data Preparation and Migration
Data migration is one of the most underestimated parts of an ERP implementation.
Most teams assume it is a technical step: export the data, import it into the new system, and move on.
In practice, this is where many issues begin.
If the data entering SAP Business One is incomplete, inconsistent, or poorly structured, those problems do not remain in the background. They show up in reporting, inventory accuracy, and day-to-day transactions.
In most implementations, the quality of your data going in determines how much you trust the system's output.

Clean and Validate Your Data Before Migration
Before anything is imported, your data needs to be reviewed.
That typically includes:
- Customer and vendor records
- Item master data (SKUs, units of measure, pricing)
- Inventory quantities and locations
- Open transactions (orders, payables, receivables)
Common issues that show up during this process:
- Duplicate records
- Inconsistent naming conventions
- Missing or outdated information
- Inventory discrepancies between systems
These problems are easy to ignore in legacy systems because teams are used to working around them.
In a new ERP system, those same issues cause confusion from the start.
In most implementations, companies that invest time in upfront data cleaning experience fewer issues during testing and after go-live.
Decide What Data Actually Needs to Move
Not all historical data needs to be migrated.
This is a decision point that affects both cost and system usability.
Most companies choose to migrate:
- Active customers and vendors
- Current inventory balances
- Open transactions
- General ledger balances
Older historical data is often:
- Archived in a separate system
- Maintained in read-only format for reference
Trying to move everything, especially years of historical transactions, adds complexity without much operational value.
In real-world deployments, focused data migration leads to a cleaner system and faster implementation.
Define Data Mapping and Structure Early
Data migration is not just about moving information. It is about aligning it to the new system.
That requires clear data mapping.
For example:
- How legacy account structures map to the new chart of accounts
- How item categories and product groups are organized
- How warehouse locations and bins are defined
- How units of measure are standardized
If this mapping is not defined early, issues tend to surface during testing, such as transactions not posting correctly or reports not matching expectations.
This is one of the more common causes of delays in ERP projects.
Run Multiple Data Migration Tests
Data migration should never be a one-time event.
Best practice is to run multiple test migrations before go-live.
Each cycle helps validate:
- Data accuracy
- System behavior
- Reporting outputs
- Integration points
In most implementations, the first migration highlights issues. The second and third refine the process.
Skipping these test cycles increases the risk of errors during go-live, when time to fix them is limited.
Cost Considerations: Data Preparation
Data preparation and migration typically account for 15–25% of the total implementation cost.
This includes:
- Data cleanup and validation
- Mapping and transformation
- Migration testing cycles
- Reconciliation and verification
This is also one of the areas where internal effort is highest.
Your team knows the data best. That means they are heavily involved in:
- Identifying errors
- Validating balances
- Confirming accuracy after migration
When internal time is underestimated, this phase becomes a bottleneck.
Where Data Migration Projects Go Wrong
This phase often creates issues when it is treated as a technical task rather than a business responsibility.
Common problems include:
- Migrating inaccurate or incomplete data
- Trying to move too much historical data
- Not reconciling financial and inventory balances
- Skipping test migrations
- Rushing data cleanup to stay on schedule
These issues typically do not show up immediately. They surface after go-live, when reporting does not match expectations, or users lose confidence in the system.
What Good Data Migration Looks Like
A successful data migration is not just about completing the transfer.
It results in a system that users trust.
You should have:
- Clean, consistent master data
- Accurate opening balances
- Reconciled financial and inventory data
- Clear documentation of what was migrated and what was archived
At that point, the system starts from a reliable baseline.
And in most implementations, that baseline is what determines how quickly teams adopt the system and rely on it for decision-making.
SAP Business One Implementation Phase 4: System Configuration and Testing

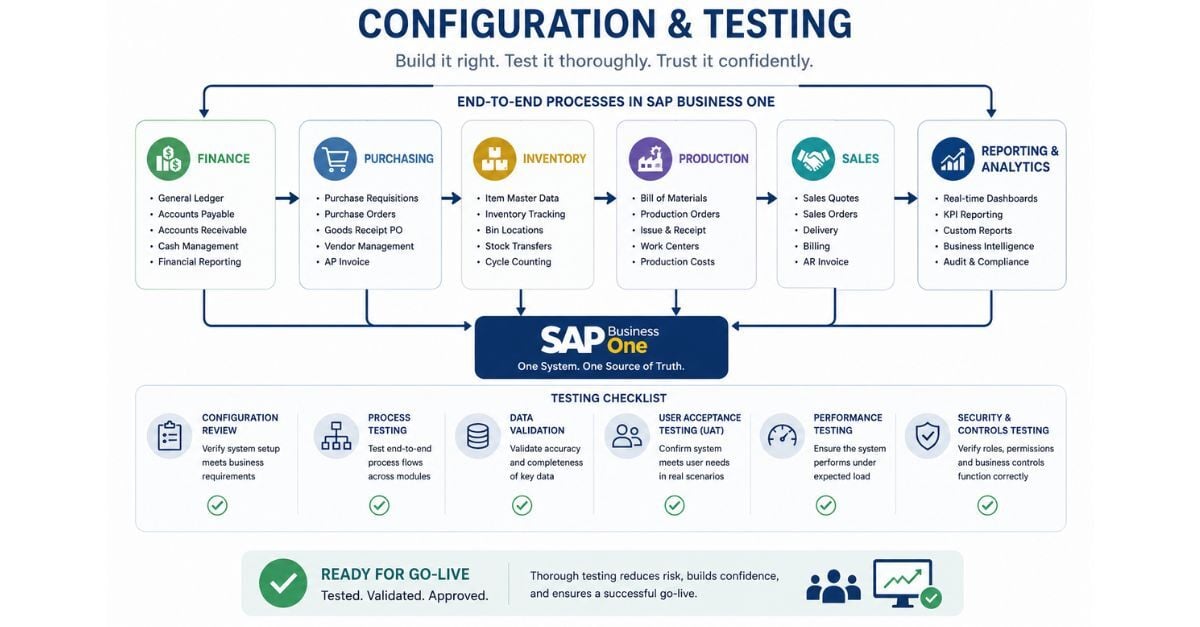

This is the stage where the system starts to become real.
Up to this point, the project has been about planning, decisions, and preparation. Now those decisions are being translated into how SAP Business One will work across finance, inventory, purchasing, production, and reporting.
This is also the point at which small setup decisions start to have real consequences. How transactions are posted, how inventory moves, how approvals work, and what reports leadership sees all begin to take shape here.

Configure the System Around the Business
SAP Business One is not ready out of the box for your company's operations.
It has to be configured to reflect how work gets done.
That includes things like:
- How financial transactions should post
- How purchasing and sales workflows should move
- How inventory should be tracked across warehouses or locations
- How production or service processes should be handled
- How approvals and controls should be applied
Some of these decisions seem minor at first, but they are not.
A chart of accounts structure can affect how flexible reporting is later. Inventory setup affects how accurately teams can receive, transfer, pick, and fulfill.
Workflow decisions affect both internal control and how quickly people can get work done.
In most implementations, the goal is not to copy the old system line for line.
It is to set up the new system in a way that better supports the business.
When Gaps Show Up
As configuration progresses, teams often encounter areas where the system does not exactly match the current process.
That is normal.
When that happens, there are usually three practical choices:
- Use standard configuration
Adjust the process so it works within SAP Business One's built-in functionality - Use an add-on
Bring in a proven third-party tool for a specific requirement - Build a customization
Develop something new when there is a clear business need, and the value justifies it
This is where discipline matters.
In real-world implementations, too much customization usually creates more burden than benefit. It adds cost, makes upgrades harder, and gives the business more to maintain over time.
That does not mean customization is always wrong. It means it should be used carefully and for the right reasons.
In most cases, companies are better served by staying close to standard functionality unless a process truly creates operational value or competitive advantage.
Testing Is Where the Project Gets Honest
Testing is where the project stops being theoretical.
This is when finance, operations, purchasing, warehouse, and production teams start working through real transactions to see whether the system behaves as expected.
That may include:
- Entering sales orders and purchase orders
- Receiving inventory and moving stock between locations
- Processing production transactions
- Posting financial activity
- Running reports and checking whether the numbers tie out
This is also when issues start showing up.
Finance may find that transactions are posting differently than expected. Operations may realize that inventory movement does not reflect how goods flow through the warehouse. Leadership may see that reports are technically correct but not useful in the format they need.
That is normal. Testing is supposed to surface those issues before the business goes live in the system.
Run More Than One Testing Cycle
Testing should not happen once at the end.
It needs to happen in rounds.
Most implementations go through:
- Unit testing, where individual functions are checked
- Process testing, where end-to-end workflows are run across departments
- User acceptance testing (UAT), where actual users validate the system against their day-to-day work
The first round usually reveals the most. Later rounds are where the system gets refined, and teams confirm that the fixes actually solved the problem.
When testing is rushed, skipped, or treated as a formality, issues tend to reappear after go-live, when the cost of fixing them is much higher, and the business is already relying on the system.
Cost Considerations in This Phase
Configuration and testing usually account for 30% to 50% of total implementation effort.
That includes:
- System setup and configuration
- Workflow and reporting design
- Multiple testing cycles
- Fixes, adjustments, and retesting
This is often where the most consulting time is spent.
It is also where delays become expensive.
Slow decision-making, missed testing sessions, or incomplete feedback can quickly drag out this phase, as much of the project is validated here.
Where Companies Run into Trouble
This phase tends to expose the effects of earlier decisions.
The most common problems include:
- Trying to rebuild every legacy process exactly as it was
- Customizing too much too early
- Not having the right people involved in testing
- Rushing through testing to stay on schedule
- Discovering too late that departments were working from different assumptions
When those issues are not resolved here, they often carry over to go-live.
At that point, what could have been a manageable correction becomes a disruption to daily operations.
What Good Configuration and Testing Looks Like
By the end of this phase, the team should know the system can withstand real operating conditions.
That means:
- Transactions are posting correctly and consistently
- Workflows reflect how teams actually work
- Reports support financial and operational decision-making
- Users know how to complete the tasks they are responsible for
The goal is not perfect in every detail.
The goal is confidence that the system is ready for the business to run through it.
And in most implementations, that confidence comes from disciplined testing, not from assuming the setup is right because it looked good in a workshop.
SAP Business One Implementation Phase 5: Training, Change Management, and User Adoption
At this stage, the system may be configured and tested, but that does not mean the business is ready.
ERP success depends on whether people use the system correctly.
This is where many projects start to struggle. Not because the system does not work, but because users are unsure how to operate within it or fall back on old habits.
Training Is About Doing the Job, Not Learning the Software
Training often gets treated as a final step. A few sessions before go-live, a walkthrough of screens, and then the system is handed off to users.
That approach rarely works.
Effective training focuses on how people do their jobs inside the system.
For example:
- How a sales order moves from entry to fulfillment
- How purchasing decisions are made and recorded
- How inventory is received, moved, and counted
- How financial transactions flow through to reporting
Users do not need to understand every feature. They need to understand what they are responsible for and how to complete that work correctly.
In most implementations, role-based training is far more effective than generic system overviews.
Use a Train-the-Trainer Model
One of the more effective approaches is a train-the-trainer model.
Instead of relying entirely on consultants to train every user, you develop a small group of internal experts who:
- Learn the system in detail
- Understand how it applies to your specific processes
- Train the rest of the organization
This creates internal ownership.
It also gives your team a resource they can rely on after go-live, instead of depending entirely on external support.
Prepare for Process Change
ERP implementation changes how work gets done.
Approvals may move into the system.
Manual steps may be removed.
Reporting may be centralized rather than built into spreadsheets.
That change is often where resistance comes from.
In most implementations, the challenge is not learning new screens. It is adjusting to new processes.
Common reactions include:
- "This is not how we used to do it"
- "The old way was faster"
- "I still need my spreadsheet to track this"
Ignoring that resistance does not make it go away.
The better approach is to address it early:
- Explain why processes are changing
- Show how the new system improves accuracy or visibility
- Give users time to adjust before go-live
Reinforce Adoption After Go-Live
Training does not end at go-live.
In fact, most learning happens after users start working in the system every day.
That is when:
- Questions come up
- Edge cases appear
- Workarounds are tested
- Gaps in understanding become visible
In most implementations, companies that plan for follow-up training sessions see better adoption and fewer long-term issues.
This might include:
- Refresher sessions for key roles
- Targeted training based on real issues
- Open Q&A sessions with users
Cost Considerations: Training and Change Management
Training and change management typically account for 10–20% of total implementation effort.
This includes:
- Training sessions and materials
- Internal time spent learning and practicing
- Process documentation
- Post-go-live support and follow-up training
This is often one of the first areas companies try to reduce to control costs.
In practice, that usually leads to:
- Lower adoption
- More support requests
- Slower productivity after go-live
Well-structured training reduces those issues and helps the business stabilize faster.
Where User Adoption Breaks Down
This phase tends to expose whether the organization is ready for change.
Common issues include:
- Relying on one-time training sessions
- Not tailoring training to specific roles
- Limited involvement from department leaders
- Allowing old processes to continue alongside the new system
- Lack of follow-up after go-live
When adoption is weak, the system may technically work, but the business does not fully benefit.
What Good Adoption Looks Like
Successful adoption is not just about users logging into the system.
It shows up in how work gets done.
You start to see:
- Transactions entered consistently and correctly
- Reduced reliance on spreadsheets and workarounds
- Teams using the system as the primary source of information
- Fewer support issues over time
- Increased confidence in reporting and data
At that point, the system becomes part of daily operations, not something users have to work around.
SAP Business One Implementation Phase 6: Go-Live and Stabilization
Go-live is a milestone, but it is not the finish line.
This is the point at which the business begins running in SAP Business One. Transactions are real, reporting is clear, and any gaps in process, training, or configuration are quickly visible.
Even well-prepared organizations experience some disruption during this transition.
The goal is not to avoid issues entirely.
The goal is to manage them without affecting core operations.
Prepare for Go-Live
A smooth go-live starts with preparation.
Before switching over, the team should confirm:
- Financial balances reconcile correctly
- Inventory quantities match expected levels
- Open transactions are accurate and complete
- User roles and permissions are set correctly
- Backup and recovery procedures are in place
This is also the time to finalize timing.
Some companies choose a hard cutover (all at once). Others use a phased approach (by department or location).
The right choice depends on operational complexity and risk tolerance.
In most implementations, issues at go-live are not caused by the system itself.
They come from gaps that were missed or not fully resolved during earlier phases.
Expect a Short-Term Productivity Dip
Even with strong preparation, performance usually slows down at first.
Users are still learning.
Processes feel different.
Tasks that were routine in the old system take more time in the new one.
In most implementations, companies experience a temporary 5–10% drop in productivity in the first few weeks.
That is normal.
Planning for this, whether through additional staffing, adjusted timelines, or reduced workload, helps avoid unnecessary pressure during the transition.
Monitor Daily Operations Closely
Once the system is live, visibility becomes critical.
The first few weeks should include:
- Daily check-ins with key departments
- Tracking of issues as they arise
- Clear ownership for resolving problems
- Quick feedback loops between users and the implementation team
Common early issues include:
- Posting errors in financial transactions
- Inventory discrepancies or timing issues
- Workflow misunderstandings
- Reporting inconsistencies
These are expected. What matters is how quickly they are identified and resolved.
Stabilization: Turning the System into a Reliable Tool
Stabilization is the period where the system moves from "new" to "normal."
During this time:
- Issues are resolved, and processes are refined
- Users become more comfortable with daily tasks
- Reporting becomes more consistent and trusted
- Workarounds are identified and eliminated
In most implementations, this phase lasts 30 to 60 days.
The companies that stabilize fastest are usually the ones that:
- Stay engaged after go-live
- Continue structured check-ins
- Address issues directly instead of working around them
Cost Considerations: Go-Live and Stabilization
This phase typically accounts for only a small portion of consulting costs, but it does require planning.
Costs may include:
- Post-go-live support from your implementation partner
- Additional internal time to resolve issues
- Temporary productivity loss
- Follow-up training or process adjustments
Companies that underestimate this phase often feel pressure immediately after go-live, when the business expects everything to run perfectly.
In practice, stabilization is part of the implementation, not an exception to it.
Where Go-Live Goes Wrong
This phase tends to expose whether earlier work was done thoroughly.
Common issues include:
- Rushing go-live before testing is complete
- Limited support availability after launch
- Unclear ownership for resolving issues
- Users reverting to old processes or spreadsheets
- Leadership stepping back too early
The system itself rarely causes these problems.
They usually trace back to gaps in planning, training, or testing.
What a Successful Go-Live Looks Like
A successful go-live is not one without issues.
It is one in which the business continues to operate while issues are addressed in a controlled manner.
You should see:
- Transactions are being processed in the new system
- Issues were identified quickly and resolved with clear ownership
- Users are gaining confidence day by day
- Reporting is becoming more consistent over time
Within a few weeks, the system should begin to feel like part of normal operations rather than a new layer of complexity.
At that point, the implementation has moved beyond launch and into long-term use.
SAP Business One Implementation Timeline and Cost Overview
One of the most common questions companies ask early is: How long will this take, and what will it cost?
The answer depends on the scope, complexity, and the organization's preparedness going into the project.
In most implementations, timeline and cost are not driven by the software itself.
They are driven by how clearly the business defines requirements, how clean the data is, and how consistently the internal team participates.

Typical Implementation Timelines
SAP Business One implementations generally fall into three categories:
|
Project Type |
Typical Duration |
Complexity Level |
Relative Cost |
|
Small (core financials, limited users) |
12–16 weeks |
Low |
$$ |
|
Mid-sized (multiple departments, light manufacturing or distribution) |
16–24 weeks |
Moderate |
$$$ |
|
Complex (multi-site, integrations, advanced workflows) |
20–40 weeks |
High |
$$$$ |
These ranges assume:
- Active participation from internal teams
- Timely decision-making
- Limited custom development
- Clean and prepared data
When those conditions are not met, timelines tend to extend.
What Actually Drives Timeline
In real-world implementations, delays are rarely caused by system setup.
They usually come from:
- Unclear or changing requirements
- Slow feedback during configuration and testing
- Data issues were discovered late in the project
- Limited availability of internal resources
- Dependencies on third-party integrations
When decisions are delayed, configuration pauses. When testing is incomplete, issues carry forward. Over time, those small delays add up.
Typical Cost Breakdown
The SAP Business One implementation cost is not a single number. It consists of several components.
Most projects include:
- Software licensing
User licenses (subscription or perpetual) - Implementation services
Configuration, data migration, testing, and project management - Add-ons and integrations
Industry-specific tools, reporting solutions, or system integrations - Internal effort
Time spent by your team on data preparation, testing, and training - Training and change management
Preparing users and supporting adoption
In most implementations, the largest portion of cost is not the software; it is the work required to align the system with the business.
Relative Cost by Phase
While every project is different, cost is typically distributed across phases:
- Planning: 10–15%
- Scoping and partner selection: 25–35%
- Data preparation: 15–25%
- Configuration and testing: 30–50%
- Training and adoption: 10–20%
- Go-live and stabilization: variable (support-focused)
This is not exact, but it gives a realistic view of where effort is spent.
Why Projects Go Over Budget
Most cost overruns are not caused by unexpected technical issues.
They are often tied to scope, data, and decision-making challenges, patterns consistently reflected in broader ERP implementation statistics and challenges across ERP projects.
They usually come from:
- The scope was not clearly defined early
- Changes introduced during configuration
- Additional reporting or integration requirements
- Data cleanup is taking longer than expected
- Underestimating internal time and involvement
In many cases, the project is not "over budget" so much as "under-scoped" at the beginning.
How to Keep Timeline and Cost Predictable
Companies that stay on track tend to follow a few consistent practices:
- Define requirements clearly before implementation begins
- Assign dedicated internal resources with decision-making authority
- Keep scope controlled through a structured change process
- Invest time in data cleanup early
- Participate actively in testing and validation
These are not complex strategies, but they require discipline.
What to Expect Overall
For most small to mid-sized businesses, SAP Business One implementation is measured in months, not weeks, and requires a meaningful internal commitment.
When planned and executed well, the result is:
- Faster and more reliable reporting
- Improved inventory and operational visibility
- Reduced manual work and reconciliation
- A system that can support growth without constant workarounds
When rushed or loosely defined, the same project becomes longer, more expensive, and harder to stabilize.
Common SAP Business One Implementation Pitfalls (and How to Avoid Them)
Most SAP Business One implementation problems do not start with the software.
They usually start earlier during planning, scoping, testing, or user preparation when a decision seems manageable in the moment but creates bigger issues later.
Different companies run into different versions of the same problems, but the root causes are usually familiar.
If you know where projects tend to lose momentum or clarity, it becomes much easier to avoid those outcomes.

1. Starting Without Clear Requirements
Many companies begin with the right goals but lack a sufficient definition of what the system actually needs to support.
That gap usually shows up later as scope changes, conflicting expectations, and rework during configuration or testing.
How to avoid it:
Spend time upfront documenting workflows, reporting needs, pain points, and operational priorities.
A project does not need every detail on day one, but it does need enough clarity to guide decisions.
2. Underestimating Data Cleanup
Data migration is often treated like an import exercise when it is really a business-cleanup effort.
If customer records are inconsistent, item data is incomplete, or balances do not reconcile, those problems do not disappear in the new system. They usually become more visible.
How to avoid it:
Assign ownership for data cleanup early. Review key records, validate balances, and determine which records should be migrated versus archived before the migration work begins.
3. Trying to Make the New System Behave Exactly Like the Old One
This is one of the most common mistakes in ERP projects.
Teams are familiar with the legacy system, so there is a natural tendency to recreate every screen, workflow, or workaround in the new environment.
That usually leads to excessive customization and insufficient process improvement.
How to avoid it:
Use the implementation as a chance to simplify where possible. Keep what genuinely supports the business. Challenge what exists only because the old system required it.
4. Choosing a Partner Based Mostly on Price
Cost matters. But choosing an implementation partner based primarily on the lowest estimate often leads to a different kind of expense later.
That may show up as weak scoping, more change requests, limited support, or a lack of structure once the project gets underway.
How to avoid it:
Look at partner fit, industry experience, implementation methodology, and transparency alongside price. The goal is not just to start the project cheaply. It is to finish it well.
5. Weak Internal Ownership
Even with a strong partner, the project will struggle if the business is not engaged.
When ownership is unclear, decisions sit too long, testing is delayed, and issues move between teams without resolution.
How to avoid it:
Make roles clear early. Executive sponsorship, a strong internal project lead, and active department participation make a significant difference in keeping the project moving.
6. Rushing Testing to Protect the Timeline
This usually feels harmless in the moment. The project is behind, the team wants to catch up, and testing gets compressed.
The problem is that testing is where process, posting, and reporting issues are supposed to show up. If that work is rushed, the problems do not go away.
They just moved into go-live.
How to avoid it:
Protect testing time.
Run multiple cycles, involve the right users, and treat testing as a genuine validation step rather than a final box to check.
7. Treating Training as a One-Time Handoff
A few training sessions before go-live are rarely enough.
People usually need to see the system in context, use it in realistic scenarios, and then revisit questions as they work with it every day.
How to avoid it:
Make training role-based, practical, and ongoing.
Users need to understand how to do their work in the system, not just where to click.
8. Ignoring Change Management
A new ERP system changes how work gets done. That is the point.
But if those process changes are not communicated clearly, teams often fall back on spreadsheets, side processes, or the old way of doing things.
That slows adoption and weakens the system's value.
How to avoid it:
Talk about process change early.
Explain what is changing, why it matters, and what teams should expect.
Adoption improves when people understand the reason behind the change.
9. Treating Go-Live Like the End of the Project
Go-live matters, but it is not the point where the work is over.
The first few weeks after launch are usually when the business finds out how well training, testing, and planning hold up under daily use.
How to avoid it:
Plan for post-go-live support, structured issue tracking, and follow-up check-ins. Stabilization is part of implementation, not extra work after the fact.
What These Pitfalls Usually Have in Common
Very few of these problems start with the software itself.
They usually come back to the same issues:
- unclear expectations
- inconsistent ownership
- weak process definition
- delayed decisions
- lack of preparation
That is why implementation discipline matters so much. Companies rarely get into trouble because SAP Business One cannot do the job. They get into trouble when the project is not structured tightly enough to make good decisions at the right time.
A Practical Way to Think About Risk
ERP implementation is not about creating a project with no issues.
That is not realistic.
The real goal is to surface the right issues early, while they are still manageable, and avoid the ones that create lasting disruption after go-live.
The companies that get the best results are not the ones with perfect projects.
They are the ones who catch problems early and address them before they start affecting adoption, reporting, or day-to-day operations.
Is SAP Business One the Right Fit for Your Business?
ERP selection is not just about features. It is about fit.
By the time companies reach this stage, they are usually not asking what SAP Business One does.
They are asking whether it aligns with how their business operates and whether it will hold up as they grow.
SAP Business One is designed for small to mid-sized companies that need more structure, visibility, and control than entry-level systems can provide, without the complexity of enterprise ERP platforms.

When SAP Business One Is a Strong Fit
In most implementations, SAP Business One works well for companies that are:
- Outgrowing accounting software like QuickBooks or Sage
- Struggling with disconnected systems across finance, inventory, and operations
- Managing increasing complexity in inventory, production, or distribution
- Relying heavily on spreadsheets for reporting or coordination
- Lacking real-time visibility into margins, inventory, or operational performance
- Planning for growth in users, locations, or transaction volume
At this stage, the issue is usually not effort. It is structure.
SAP Business One provides a single system that connects financials, inventory, purchasing, production, and reporting.
For smaller manufacturers comparing platforms, it can also be helpful to evaluate where SAP Business One fits as an SAP Business One alternative for small manufacturers when flexibility, operational visibility, and implementation fit are part of the decision.
That alignment allows teams to operate with more consistency and less manual reconciliation.
When SAP Business One May Not Be the Right Fit
SAP Business One is not designed for every organization.
It may not be the best fit if:
- You operate at a large global enterprise scale with complex regulatory requirements
- You need highly specialized industry functionality beyond standard ERP capabilities
- Your environment requires a fully SaaS-only solution with no flexibility in deployment
- Your processes require deep customization across nearly every functional area
In those cases, companies often look toward enterprise platforms such as SAP S/4HANA or other systems designed for more complex global operations.
Decision Framework: How to Evaluate Fit
If you are evaluating SAP Business One, a few practical questions can help guide the decision:
- Do your current systems require frequent manual reconciliation?
- Are inventory and financial data consistently aligned?
- Can leadership access reliable reporting without delay?
- Are processes standardized across departments, or dependent on individual workarounds?
- Will your current system support your next phase of growth?
If the answer to several of these questions is no, it is usually a sign that the business has outgrown its current systems.
What ERP Should Ultimately Deliver
Regardless of platform, the goal of ERP is not just consolidation.
It should provide:
- Clear, reliable financial reporting
- Accurate, real-time inventory visibility
- Structured, repeatable processes across departments
- Reduced reliance on spreadsheets and manual work
- A foundation that can support growth without constant rework
SAP Business One addresses these areas for many small and mid-sized organizations, but only when it is implemented with the right structure and discipline.
Final Thought: ERP Is an Operational Decision
ERP is often evaluated as a technology purchase.
In practice, it is an operational decision.
The system you choose will shape how your business processes transactions, manages data, and makes decisions every day.
That is why fit matters more than features.
Next Steps: Evaluating SAP Business One for Your Business
If you are considering SAP Business One, the next step is not a demo.
It is a structured evaluation of how your business operates today and what needs to improve.
That typically includes:
- Reviewing current workflows across finance, inventory, and operations
- Identifying reporting gaps and manual processes
- Assessing data quality and system limitations
- Defining what success should look like after implementation
From there, it becomes clearer whether SAP Business One is the right fit—or whether another ERP platform would better align with your needs.
At Clients First, this process starts with understanding your operations, not presenting software.
Because the goal is not just to implement a system.
It is to implement the right system, in the right way, for how your business actually runs.
SAP Business One Implementation Frequently Asked Questions
By this point, most companies have a good understanding of the implementation process. The remaining questions are usually more specific, focused on timing, cost, risk, and what to expect during execution.
Below are some of the most common questions that come up during ERP evaluations.
How long does it take to implement SAP Business One?
Most SAP Business One implementations take between 12 and 24 weeks, depending on complexity.
Smaller projects with limited users and standard processes can be completed in 12–16 weeks. More complex environments, especially those with multiple departments, integrations, or light manufacturing, typically take 16–24 weeks or longer.
The biggest factors that affect the timeline are:
- Clarity of requirements
- Data readiness
- Internal team availability
- Speed of decision-making during the project
In most implementations, delays are caused by process and data issues—not system setup.
How much does an SAP Business One implementation cost?
Implementation costs vary by scope, but most projects fall within a range where implementation services equal or exceed the software cost.
Key cost drivers include:
- Number of users and modules
- Data migration complexity
- Integrations and add-ons
- Level of customization
- Internal resource availability
In most implementations, the largest investment is not the software itself; it is the work required to align the system with the business.
What are the biggest risks during an ERP implementation?
The biggest risks are usually not technical.
They tend to come from:
- Unclear requirements at the start
- Poor data quality
- Limited internal ownership
- Rushed testing or training
- Scope changes during the project
In real-world implementations, these issues are manageable when identified early but disruptive when discovered after go-live.
Can SAP Business One be customized to fit our business?
Yes, but customization should be approached carefully.
SAP Business One supports:
- Standard configuration (preferred in most cases)
- Third-party add-ons for specific functionality
- Custom development when necessary
In most implementations, staying close to standard functionality reduces cost, simplifies upgrades, and improves long-term stability.
Customization should be used when there is a clear operational benefit, not just to replicate legacy processes.
What happens after an ERP go-live?
After go-live, the system enters a stabilization phase that typically lasts 30 to 60 days.
During this time:
- Issues are identified and resolved
- Users become more comfortable with the system
- Processes are refined based on real usage
- Reporting becomes more consistent
Most companies experience a short-term productivity dip during this period, followed by improved efficiency as the system becomes part of daily operations.
How do you know if your business is ready for an ERP system?
Most companies reach ERP readiness when:
- Current systems no longer scale with transaction volume
- Reporting requires significant manual effort
- Inventory or financial data is inconsistent
- Teams rely heavily on spreadsheets or disconnected tools
- System constraints are limiting growth
At that point, the issue is not software capability; it is a lack of integration and process alignment.
Final Perspective
SAP Business One implementation is not a quick upgrade.
It is a structured operational effort that affects how your business reports, buys, sells, produces, and makes decisions every day.
When a project is well planned, the impact goes far beyond simply replacing old software.
Financials become more reliable. Inventory becomes more visible.
Teams spend less time reconciling data and more time acting on it.
That is where ERP starts to create real value.
But that outcome is not automatic.
In most implementations, success depends less on the software than on the discipline behind the project.
Clear requirements, clean data, consistent ownership, realistic testing, and strong user adoption are what determine whether SAP Business One becomes a platform the business can rely on.
For manufacturers, distributors, and growing companies dealing with operational complexity, that distinction matters.
The right ERP system can support growth.
The wrong implementation approach can delay it.
If you are evaluating SAP Business One, the next step is not just to schedule a demo.
It is time to step back and assess how your business operates today, where visibility is limited, which processes are creating friction, and what a successful outcome should look like after go-live.
At Clients First, that is where the conversation starts.
We work with companies to evaluate current workflows, define a realistic scope, and determine whether SAP Business One is the right fit for the way the business runs.
If you are planning an SAP Business One implementation, the next step is a structured evaluation. That gives you a clearer view of the timeline, cost, process fit, and implementation risk before the project begins.
